Factory Pasture Lane Sidewalk

Sebago Technics was retained by the Town of Kennebunk to design approximately 0.70 miles of sidewalk along Factory Pasture Lane and Depot Street as part of a federally funded locally administered project (LAP) with the Maine Department of Transportation (MaineDOT).


Location

Kennebunk, Maine

Sector

Municipal

Services

  • Land Surveying
  • Traffic Engineering
  • Permitting

Completed

2022

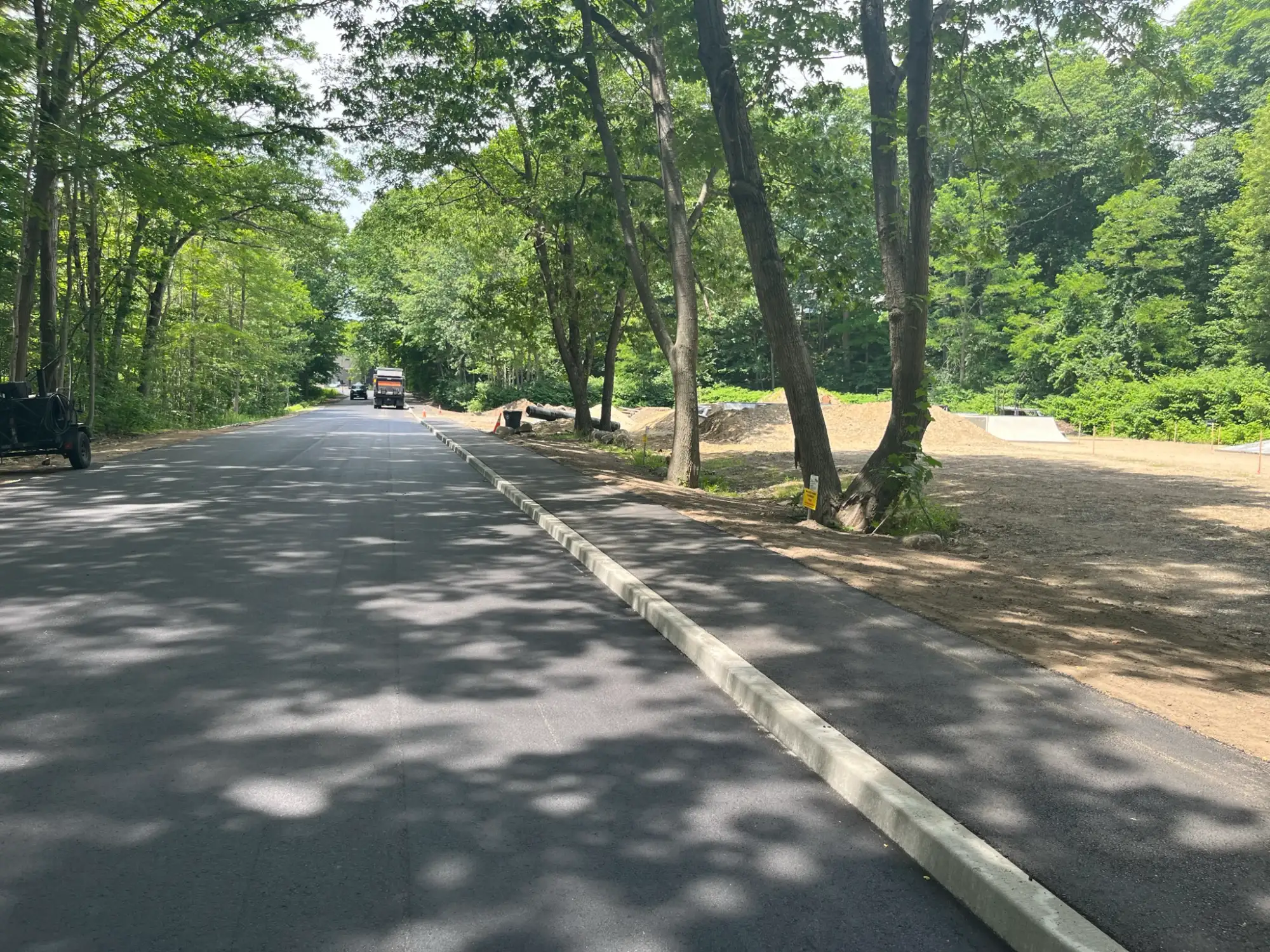

A newly paved road with fresh curbs runs through a wooded area; construction equipment and cleared land are visible on the right side.

Project overview

The project scope included new sidewalk construction on the northerly side of the road as the roadway was identified as a location of pedestrian use without existing infrastructure. As part of the project, the Town decided to reclaim the existing roadway.

project Details

Improving pedestrian walkability in Kennebunk

Sebago led the Town through the LAP process with the multimodal program at MaineDOT. A preliminary design report (PDR) was submitted for approval to progress to Plan Impacts Complete (PIC). Following the completion of the PIC submittal, Sebago coordinated the information necessary for MaineDOT to complete the NEPA process and engaged in the coordination to relocate utility poles. Additionally, the project was unique in that it was entirely comprised of a local roadway, therefore the Town was required to undertake the right-of-way process.

As such, Sebago completed the right-of-way mapping in-house and coordinated with appraisers to complete the right-of-way process with MaineDOT’s final sign-off. The process included obtaining permanent rights for the utility relocations, drainage easements, and temporary rights on all impacted parcels.

Following completion of the right-of-way process, final plans, specifications, and an estimate were developed for final Town and MaineDOT review. Following authorization from MaineDOT, the project was put out for advertisement and awarded for construction. The design phase was completed in 2021, and construction occurred in 2022, with Sebago providing full-time inspection and construction administration in compliance with LAP guidelines.
